Faro Mine Remediation Project: Yukon
Learn about the work underway to clean up the Faro Mine site.

On this page:
What is the Faro Mine?

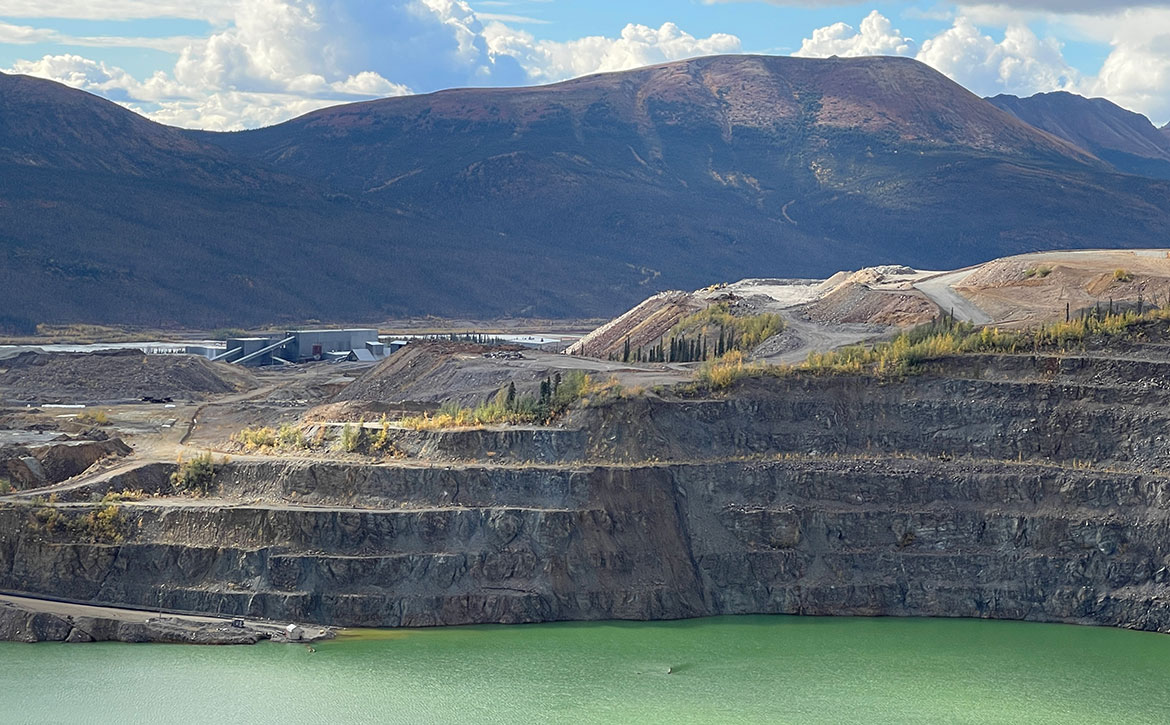

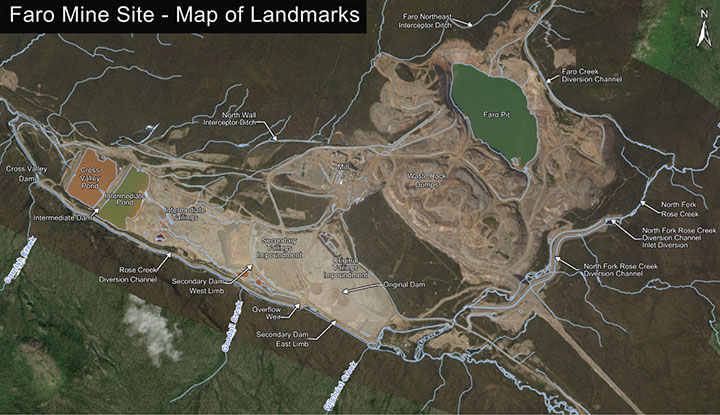

Faro Mine was once the largest open pit lead-zinc mine in the world. Today, it is the site of one of the most complex abandoned mine remediation projects in Canada. The mine spans 25 sq. km, an area roughly the size of the city of Victoria, British Columbia.
It is located in south-central Yukon, near the town of Faro, on the traditional territory of the Kaska Nations, and upstream from Selkirk First Nation. The Devolution Transfer Agreement identifies the Ross River Dena Council, Liard First Nation, Kaska Dena Council, and Selkirk First Nation as affected First Nations for the Faro Mine.
Processing the valuable minerals at the mine left behind 70 million tonnes of tailings and 320 million tonnes of waste rock. This waste has the potential to leach metals and acid into the surrounding land and water.
The mine was abandoned in 1998 and is currently in care and maintenance, which includes:
- monitoring water quality
- collecting and treating contaminated water
- ensuring that the water leaving the site meets environmental standards
- maintaining site infrastructure, including roads, buildings, dams and stream channels
What is the Faro Mine Remediation Project?
The Faro Mine Remediation Project is one of the most complex abandoned mine clean-up projects in Canada. It was established to prevent the contamination of nearby land and water from the former mining operation.
Risk mitigation work is taking place at the site to ensure it remains stable and secure. Ongoing environmental monitoring ensures that systems are working as designed and that the site remains compliant with environmental, health and safety regulations.
The highest priority issues are being addressed while the Faro Mine Remediation Project proposal proceeds through regulatory approvals. The realignment of North Fork Rose Creek is currently underway to prevent the creek from coming into contact with contaminated water on the site. Other care and maintenance and urgent works projects have previously been completed to maintain conditions at the site.
Who is responsible for the project?

Government of Canada
The Government of Canada funds the project and is leading the care and maintenance, site monitoring, consultation, remediation plan design and regulatory process.
Government of Yukon
The Government of Yukon participates in the project to ensure the interests of Yukoners are incorporated.
First Nations, the Town of Faro and other stakeholders are consulted on an ongoing basis to ensure the project incorporates their input. First Nations include the Kaska Nations (Ross River Dena Council, Liard First Nation and Kaska Dena Council) and Selkirk First Nation.
The remediation plan
The remediation plan outlines the method for cleaning up the Faro Mine site to ensure human health and safety and the protection of the environment. In 2009, after many years of research, extensive professional review and consultation, a remediation approach was selected.
Key features selected for the remediation of the site include:
- upgrading dams to ensure tailings stay in place

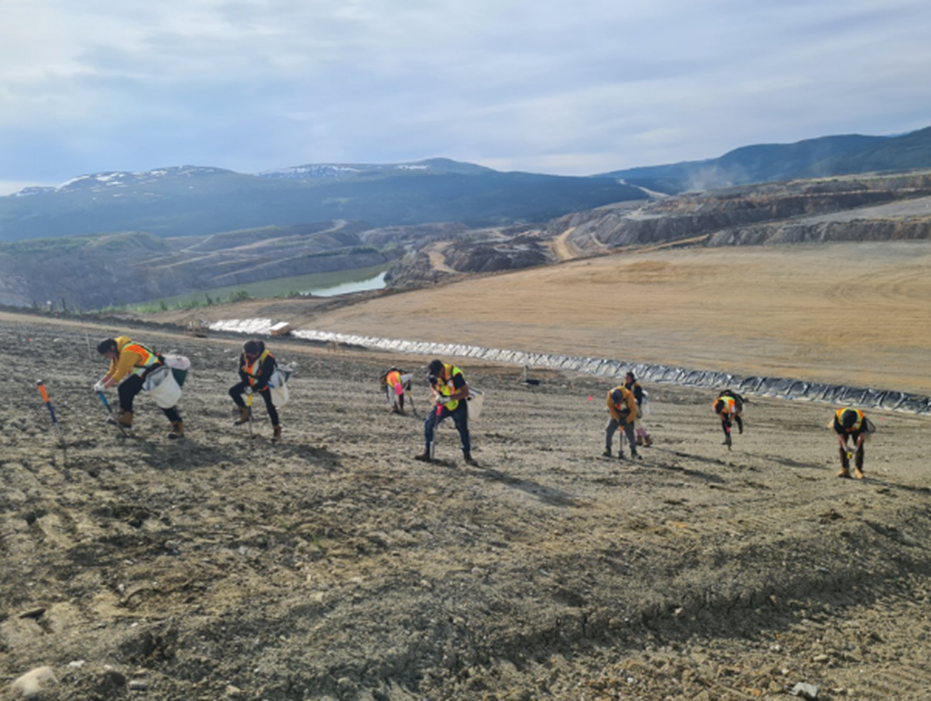

- re-shaping, covering, revegetating and establishing surface drainage on waste rock and tailings
- extending and upgrading diversion channels to keep clean water away from contamination
- improving and expanding contaminated water collection systems and building a new water treatment plant
In partnership with the Government of Yukon, the Kaska Nations, Selkirk First Nation and other affected and interested groups, the Faro Mine Remediation Project team established five critical objectives for the remediation plan:
- protect human health and safety
- protect and, to the extent practicable, restore the environment including land, air, water, fish and wildlife
- return the mine site to an acceptable state of use that reflects pre-mining land use where practicable
- maximize local and Yukon socio-economic benefits
- manage long-term site risk in a cost-effective manner
Timeline
Key dates in the remediation project:
- 1969 to 1998: processing of minerals left behind waste rock and finely crushed particles, known as tailings
- 1998: Faro Mine is abandoned when the owner declares bankruptcy
- 2003: Devolution Transfer Agreement takes effect, Faro Mine identified as a shared responsibility between the Government of Yukon and the Government of Canada
- 2005: remediation objectives are selected
- 2009:
- Government of Yukon takes over responsibility for care and maintenance at the site
- remediation approach is selected
- 2010: grum sulphide cell constructed with engineered covers to protect environment from contaminants
- 2011: contractor hired to work on research to help with remediation plan design
- 2013: old water treatment plant closed due to health and safety concerns
- 2015:

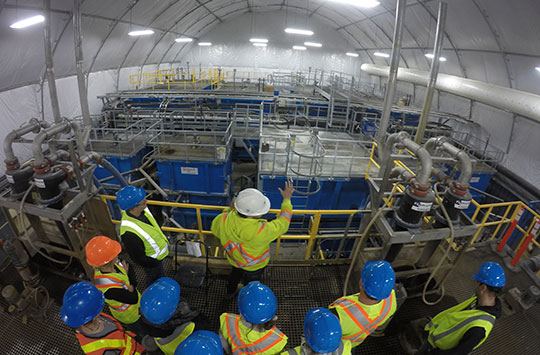

- new state-of-the-art water treatment plant in operation
- seepage collection system installed at the North Fork Rose Creek as a temporary measure to reduce zinc levels in water
- 2016: contractors hired to work on regulatory applications and design plans for urgent works and remediation
- 2018:
- Government of Canada takes over responsibility for care and maintenance of the site

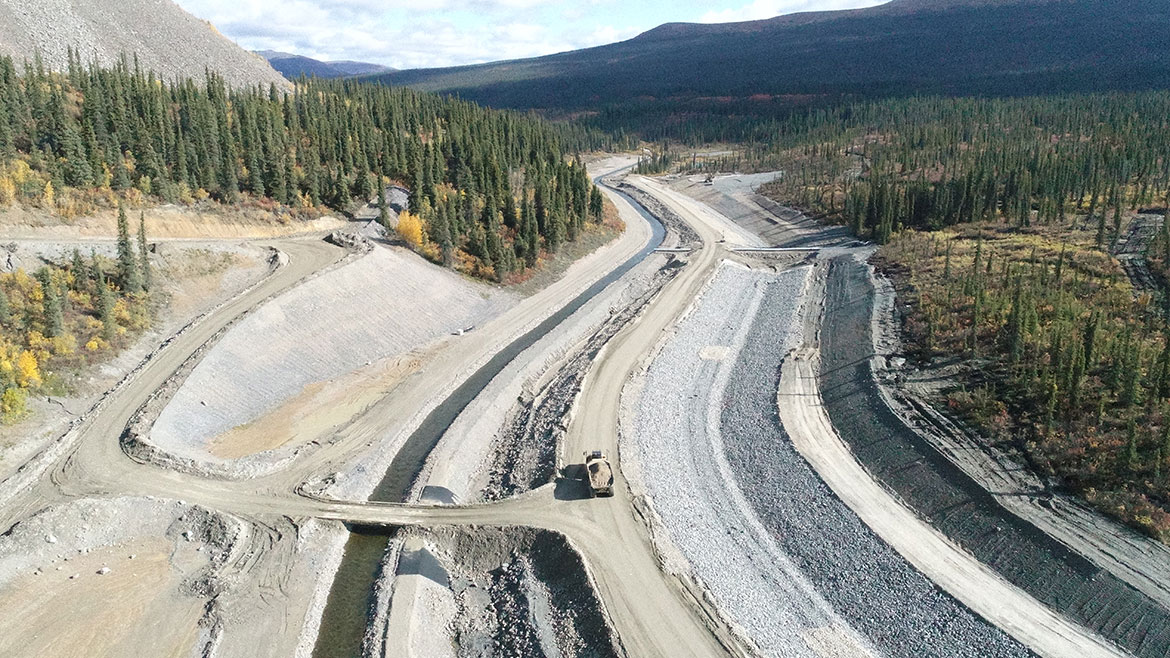

- construction begins on North Fork Rose Creek diversion
- seepage capture system constructed near monitoring station X13
- 2019:
- groundwater seepage interception systems are constructed
- the environmental and socio-economic assessment process begins
Next steps for the project and estimated dates
- 2020 to 2021: completion of North Fork Rose Creek diversion construction
- 2021 to 2022: water licence application submitted
- 2022 to 2023: all regulatory authorizations issued, completion of remediation plan design, construction manager hired for site remediation
- 2024: site remediation is expected to begin
What's next?
Following the environmental and socio-economic assessment process, an application for a water licence will be filed with the Yukon Water Board. The major construction phase is expected to begin in 2024, once all regulatory approvals are in place.
Remediation is expected to take about 15 years to complete, followed by 20 to 25 years of testing and monitoring to make any needed improvements to the site.
